FROM THE YARD · 04 OCTOBER 2026 · 6 MIN

Yacht refit in Turkey: clearing a part in, and the old one out

The crate is in the country. It has been in the country a week. The tracking record closed with a signature at a warehouse a short drive from the berth, and the yard cannot have it: nobody at the yard is in a position to ask for it.

The gate of a ship repair yard is a customs boundary before it is a logistics one. Goods cross it on paper as much as on a flatbed, and the paper names a party. Until that party is identified a part can be delivered, paid for and physically close without being fittable. The purchasing register says delivered. The fitter says nothing has arrived. Both are correct.

This is the ordinary long-lead item on a yacht refit in Turkey, or anywhere a hull lies in a foreign yard, and rarely the one the programme shows. Manufacture takes what the maker says it takes. Clearance takes as long as it takes to work out whose signature it needs, and an equipment list carrying a part number and a quantity never answers that.

Her own entry terms reach the parts bolted to her

A yacht lying in a foreign yard is there under some arrangement that treats her as a vessel visiting rather than as goods sold into the country. The detail belongs to her agent and to the terms she entered on, which are settled when the passage and the yard period are planned. The point here is narrower: she sits inside a frame, and anything bolted to her inherits it.

A part fitted to her is not simply a part bought. It joins a hull whose own presence is provisional, and the same holds in reverse for anything taken off her.

The question that follows has one answer per shipment: which party is the importer of record. Not who pays for the part, which the specification settles. Who is named as bringing it into the country. In practice that party presents the documents, answers a query and pays a charge to release the consignment, and its name is on the declaration if the declaration is wrong. An equipment list without that column is a list of items nobody is yet in a position to chase.

Three routes a part can take in, and who can act on each

A part clears customs by one of three routes, and they are not interchangeable.

Bought locally by the yard, on the yard's own account, no border sits inside the transaction. The yard buys as a domestic buyer and the item reaches the berth as an internal movement rather than a shipment anyone has to clear. It is the quickest route of the three, which is why it is worth establishing early what a Tuzla shipyard can supply locally before anything becomes an import question.

Imported by the yard on the owner's behalf, the yard is named, the yard presents and the yard chases. Slower than local supply, but the chasing then sits with people who are at the gate daily, which is worth something only if that is how the yard is in fact set up. A question to ask rather than assume.

Free-issued by the owner direct to the gate, the owner buys and the owner ships, and the consignee line says something. If it names the yard, the yard can act. If it names the yacht, the owning company, or anybody the gate does not recognise, the crate waits until somebody is appointed. Owner-supplied parts are often routed this way for a reason that looks sound at the time: the only visible cost then is the price of the part.

The two lines a refit purchase order needs before customs

A refit purchase order carries a part number, a quantity, a price and a delivery address. Two lines are missing, and only two: a delivery term, and the name of the party who will clear the shipment.

A delivery term fixes where the seller's responsibility stops and somebody else's starts. Without it that boundary is settled by assumption, and the assumptions at each end are usually different and each reasonable. The missing name is the harder omission, because it cannot be negotiated away afterwards. A consignment lying under a consignee nobody can act for can take longer to unpick than the lead time it was meant to beat.

An item held because nobody is in a position to present it does not move sooner for a faster courier, or because the office telephoned the carrier. Carriers move goods. They do not acquire standing. A shipment needs a named human at the destination end before it needs a tracking number.

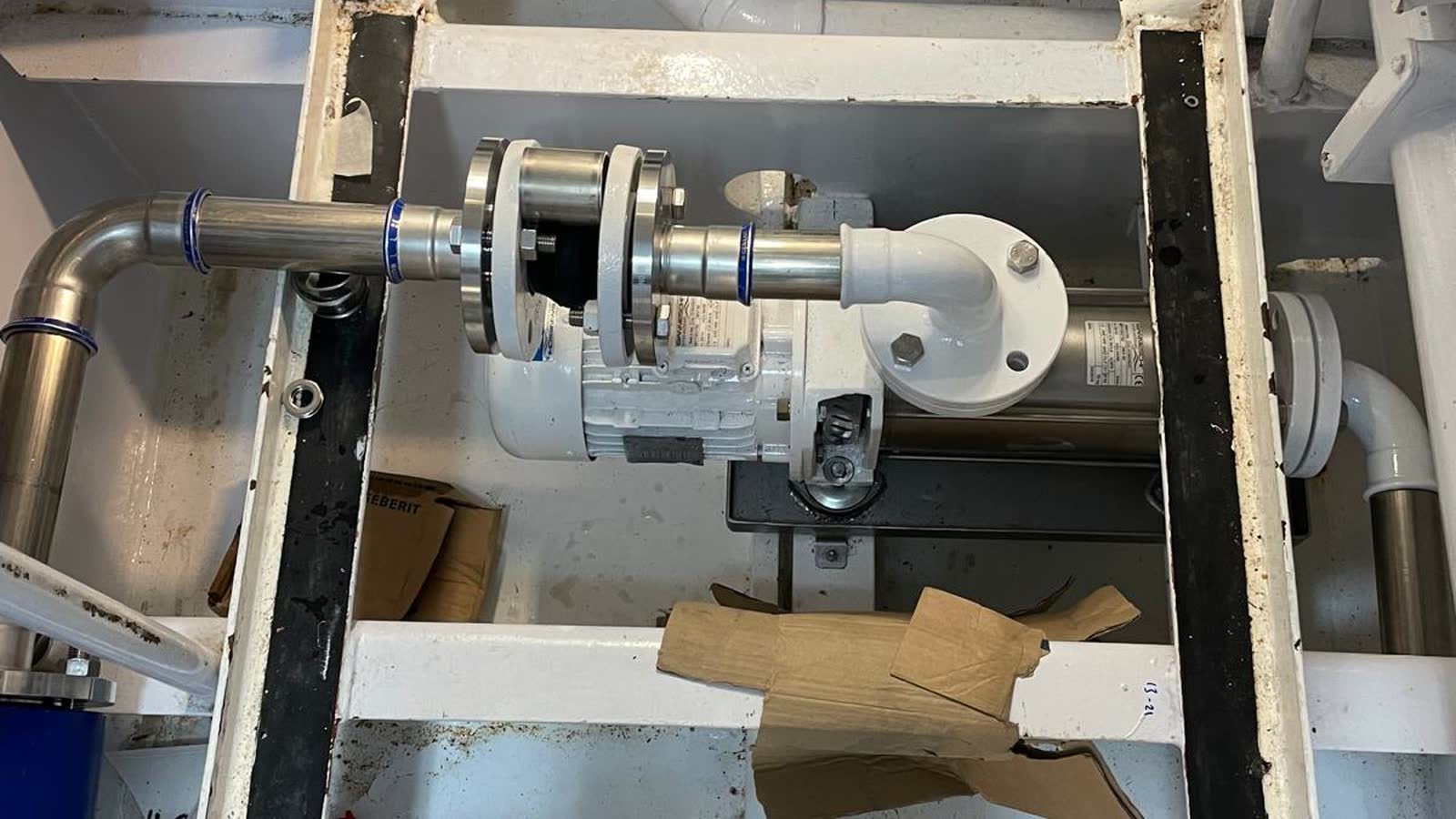

A pump set coupled to stainless flanged pipework on its bed in a compartment, with packaging still on the deck around it.
A delivered unit on its bed with the packaging not yet cleared. The route it took in was decided long before the crate reached the gate.

The half nobody orders: how the old unit leaves

An equipment list is written entirely about arrivals. A refit generates departures to match, and none of them is on the list.

A generator, a chiller, a windlass, a length of switchgear: unbolted, lifted out, then standing on a pallet behind the shed. Who owns it is one question, and a well-written specification answers it; the disposition of removed equipment is settled there rather than here. Whether it may remain in the country is a different question, and the specification does not reach that far. A unit that arrived aboard a hull herself there provisionally has to be accounted for when she leaves. Scrapped against a record, sent back out, or kept aboard as a listed spare are the usual answers; which is open in a given case belongs to her agent, and is worth asking before the unit is on the pallet.

That is a border decision as much as an ownership one, and it is the half nobody orders. It costs nothing for months. Then, at redelivery, it costs the handover.

Four things to settle before the first order goes out

It reduces to four decisions, none of which needs the programme in front of you, and all of them precede the first order.

  • A named agent, appointed for the yard period rather than per consignment, so one party's job is to know what a given shipment needs.
  • The importing party per route, written as a column on the equipment list, so every line says whether the yard or the owner is named.
  • The document set per shipment type, agreed once rather than discovered three times.
  • One standing instruction covering removals, so an item coming off is dealt with by a rule rather than by whoever is holding the spanner.

The asymmetry is what makes those four decisions worth taking early. An inbound part a week late costs whatever the activity it was holding costs, at once. An outbound item with no disposition costs nothing while the refit runs, then falls due in the one week nobody has slack left: the week she is meant to leave.

Where Reviva sits, and what to send with the equipment list

Reviva refits, repairs and rebuilds inside the Tuzla ship repair district. Purchasing and logistics are handled in house, and one named project manager reads the brief, which matters here because the route a given item takes in is a decision somebody has to own in writing.

None of that removes a border. It moves the border decision away from the gate, where it is an obstruction, back to the scoping conversation, where it is a column on a list. Send the equipment list alongside the specification and the route can be settled line by line, before any order is raised. Write to info@revivarefit.com, or start a refit.

Written at the yard in Tuzla. No customs regime, procedure or statute is described here, and none is stated to apply to any particular yacht — entry terms belong to her agent and her own documents. What an owner can fix in advance is who is named, on which line, for which shipment.

Send the equipment list with the specification

Send the specification and the equipment list together, and we will come back with a route marked against each line: what we can source locally, what we can arrange to bring in, and what is better free-issued with a consignee agreed in advance. Who is named on each shipment is confirmed with your agent rather than assumed. Removals get a disposition at the same time, rather than at redelivery. Write to info@revivarefit.com.
