FROM THE YARD · 04 OCTOBER 2026 · 6 MIN

The inspection and test plan decides what gets opened twice

A lining goes back on a Friday and comes off again on the Tuesday. Nothing behind it need have been wrong. The pipework right, the clips right, the insulation the specified grade — and the panel still comes off, because the person who had to see behind it was never named against that moment, and by the time he walks the compartment it is closed.

The second removal takes a joiner off programme work, other trades move around him, and a run of veneer that was perfect on the Friday now carries a handling mark. None of it is in anybody's price, because nobody priced a sequence in which the panel comes off twice.

A specification says what the work is. A programme says when. An inspection and test plan says where the work stops to be looked at, and it is the only one of the three that decides whether a compartment is opened twice.

What an inspection and test plan actually contains

It is a list of points in the programme where work halts until something has been looked at, measured or tested. One row per point, and the useful version carries five fields.

  • The activity, named narrowly enough that nobody has to guess which panel, which weld run, which tank.
  • The standard it is measured against: a drawing revision, a maker's data sheet, a class requirement, a retained sample.
  • The evidence the point produces. A reading, a signed record, a photograph with a scale and a date in it.
  • Who attends, by role: yard quality, owner's representative, class surveyor, maker's engineer, or nobody.
  • What closes the point, and whose signature does the closing.

One plan across every trade, not an annex bolted to the class list with joinery and coatings left out of it. Class sets its own survey items whether anybody writes them down or not. The points most easily missed are the ones class has no interest in: the first fix behind a lining, the substrate under a decorative coating, the bedding under a sole. Those have no institutional sponsor, so if the owner does not author them they do not exist.

Hold points belong where work becomes unreachable, not where it matters

The common mistake is to put the gates against the work that matters most. Ask an owner to mark up a specification and the hold points land on the engine installation, the paint and the master cabin.

That is the wrong test. Expensive work tends to be watched anyway, and by more than one person. The test is irreversibility: does this work shortly become unreachable, and what would reaching it again cost? A gate belongs wherever that answer outweighs the cost of looking now.

Applied honestly it puts hold points in unglamorous places. A systems first fix, before insulation goes over it. A tank interior, before the lid goes back on. A substrate, before the first coat covers the only evidence of how it was prepared. None of it is dramatic, and all of it is behind something shortly after.

The three columns owners leave blank

A specification that mentions hold points will often name the activity and stop there. Three columns are left for the yard to interpret, and each absence costs differently.

Who attends, and whether attendance may be waived. A point that reads only to be inspected names nobody, so it is closed by whoever happens to be standing there. If the owner's representative is meant to see it, say so; if yard quality alone is sufficient, say that too, because that is cheaper and often adequate.

What evidence closes it. Inspected and found satisfactory is a sentence rather than a record. A thickness reading is a record; so is a photograph with a scale, a date and an identifiable location in frame. A signed first-off taken against a retained finish sample is a record, which is why the sample must be a kept object, not a recollection.

And the consequence: who bears the cost of uncovering work closed without its hold point. This is the column most often left out, and without it the other two are advisory. A hold point with no consequence beside it is a request. With one, it is a hold.

It is cheap to ask for at tender stage. Model wording for the owner's own specification, put to every yard that prices it: work closed before its hold point is signed is uncovered and made good at the yard's cost, and a point recorded as waived by the attending party is properly closed. That puts the risk on whoever controls the sequence. Whether any yard accepts it unamended is a commercial matter settled at tender; written after award, the same words are a variation and priced like one.

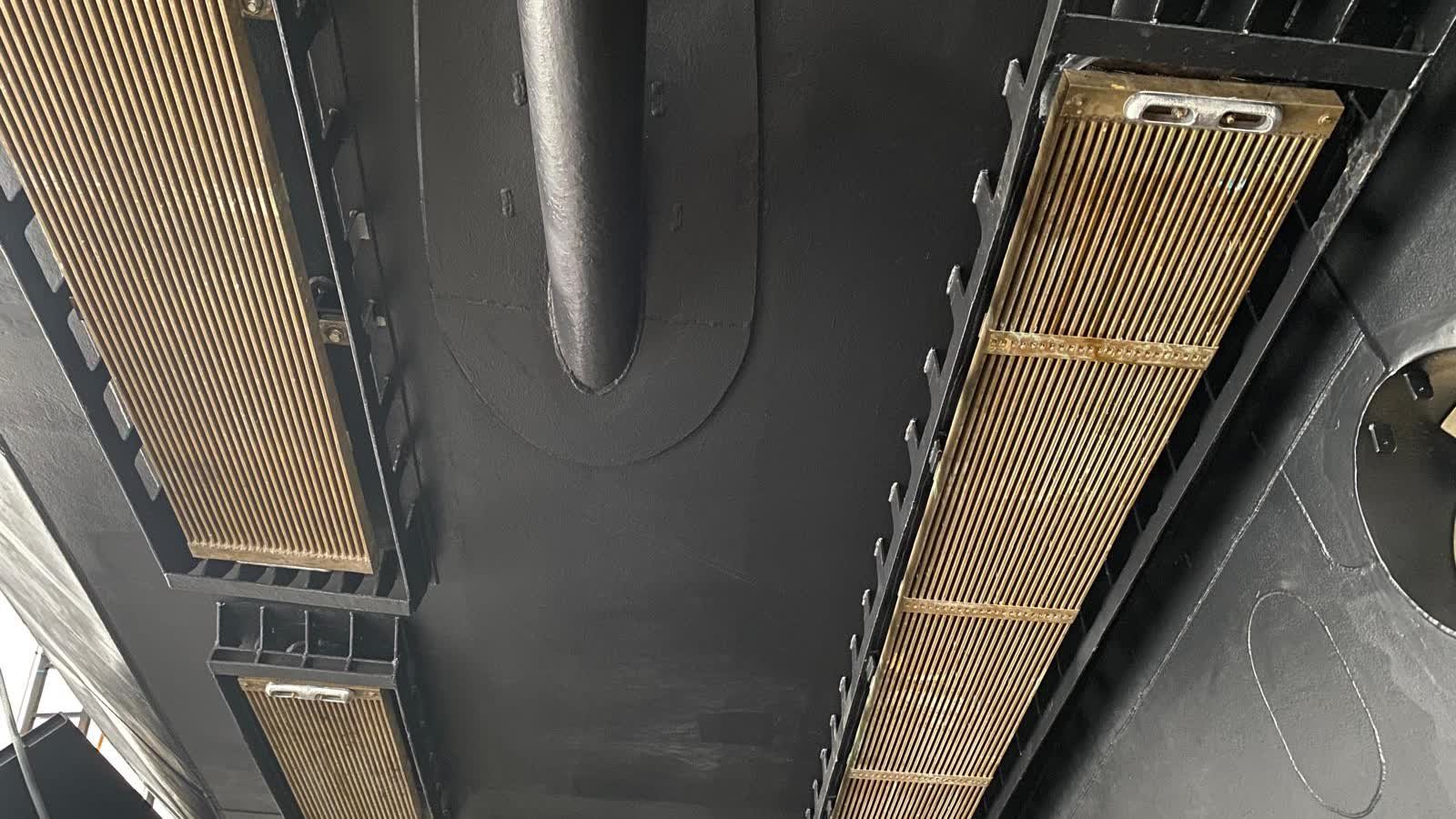

Two sea chest gratings set into the hull bottom either side of the shaft bossing, seen from below with the yacht ashore.
A grating comes off to reach what is behind it and goes back on once. Whether it comes off a second time is settled by a list written before the work starts.

The waiver clause that keeps the programme moving

The objection is fair. A gate that can only be closed in person makes the programme hostage to a diary, and with the owner's team abroad, a handful of such gates can absorb more float than the work they protect.

The answer is to say, point by point, which of two kinds each one is. Either it can only be closed in person, in which case the programme carries the waiting. Or it can be closed on an agreed record, in which case the specification has to say what that record must contain to stand in for a visit: how many photographs, taken from where, with what in frame for scale, and who signs the note that travels with them.

The second kind is where a plan earns its keep, because the sequence moves without anybody giving up oversight. Be blunt about the first. Witness-bound work will not compress whatever manning a yard puts against it, which is settled in the specification rather than in the programme.

A closed hold point is the evidence a later claim needs

Every point properly closed has already produced what a later question needs: a dated record of a condition at a moment, taken while the work was still visible. A season or two on, with the yacht a passage away, that is the difference between a warranty claim that can be assessed and one that turns on recollection. An undated photograph with nothing in it for scale is a picture of some pipework.

So the plan is not a separate quality exercise running alongside the job. Closed points are the raw material the record that leaves with her is built from, while the work is still open rather than in the last fortnight.

What a yard brings to it, and what to send

A yard's contribution is the raw material a hold point is closed from, and proximity helps. Joinery, metalwork, coatings, electrical and systems within a short walk of the berth means the trade being gated is a walk away rather than in somebody else's queue. A named project manager, rather than a mailbox, is the person whose job it is to call the point before the panel goes on. A weekly report with photographs is a stream of closed points, worth something only if somebody decided in advance what each photograph had to show.

Reviva refits and rebuilds in Tuzla, and none of that changes which points belong in the plan. The owner's draft decides that, and it belongs in a specification three yards can price rather than in an annex drafted after award. That is worth settling before signature, with a drawing and a programme in hand.

Written at the yard in Tuzla. Standards belong to the drawing, cure intervals to the coating maker's data sheet and survey items to the attending surveyor. No hold point list, inspection regime or commercial term is stated here as settled.

Mark what will shortly be unreachable

Send the specification and the draft programme with the irreversible points marked: anything that will shortly be behind a lining, under a sole, inside a tank or under coating. Ask every yard to price the uncovering consequence before you compare the figures. Write to info@revivarefit.com.
